Roofing for School Districts in Bellingham, WA
Roof planning for school districts around Bellingham, WA: summer-break work windows, bond-cycle budgets, drainage before the wet season and campus-wide grades.

Roofing for School Districts in Bellingham, WA
Roof planning for school districts around Bellingham, WA: summer-break work windows, bond-cycle budgets, drainage before the wet season and campus-wide grades.
Industries We Serve
Roofing for School Districts in Bellingham
The school calendar and the weather agree on one thing: summer. July is Bellingham's driest month, and the break is the only stretch when a crew can own a school roof. That window is about ten weeks. A district with a dozen roofs cannot fit them all inside it. So the plan has to run over several summers, and the order has to be right. A roof that waits a year may be a roof that leaks in the fall of the year before.
Annual rain in Bellingham, WA runs about 34.8 inches, and the wet peak is November. School roofs take that load with few drains and a lot of moss. Our district work gives every roof a grade and a place on a multi-summer list.
Order matters because failure order matters. Gyms and multipurpose rooms go first when the grade is low. Large spans, high parapets and rooftop ventilation make them expensive to reach, and one storm over a finished wood floor ruins it. Classroom wings come next. Storage and shops come last.
Overview
Roofing for School Districts
The district roof inventory
Bellingham School District employs about 1,423 people. A district's buildings span many ages. Original wings. Later additions. Gyms. Cafeterias. Portable classrooms. Shops. Each carries a roof of a different type and age.
We catalog every roof. Type. Age. Area. Drain count. Penetrations. Repair history. Moss load. Each gets a condition grade and a remaining-life estimate. The business office gets one ranked list. The board sees the top five and the reasoning. A gym roof over finished wood ranks above a storage shed with the same condition. We rank by what sits under the roof.
Photographs make the case for the board. Moss lines on a parapet. A ponded corner. A patched seam with a second patch beside it. Trustees see what facilities staff see. They can approve the urgent group in one meeting, with the pictures and the price on one page.
Building the summer window
The window starts the week after school lets out and closes a week before staff return. Design, submittals and orders happen the winter before. Materials land on site in June. Crews start the day the building empties.
July is the driest month, and the deck dries fast. We start early in the morning once dew lifts. We stop when evening damp returns. Tear-off goes in sections, dried in the same day. No section stays open overnight. At week's end the site is clean, with no loose material within reach of the ground. If a project slips toward September, we say so early, so the district can decide whether to hold the last section for the next summer.
Long-lead items need an early order. Membrane, insulation, curbs and edge metal all have lead times. A late order is a late start, and a late start eats the dry weeks. We confirm delivery dates in writing and keep a backup plan if a shipment slips. Where a general contractor manages the whole summer program, our roof package fits inside theirs.
Bond cycles and bid lines
School roofs are funded in packages. Bonds, levies and state programs set the cycle. Business officers need a defensible list. We write each recommendation as remaining life, consequence of delay and a cost range, then group projects into packages that fit the funding source.

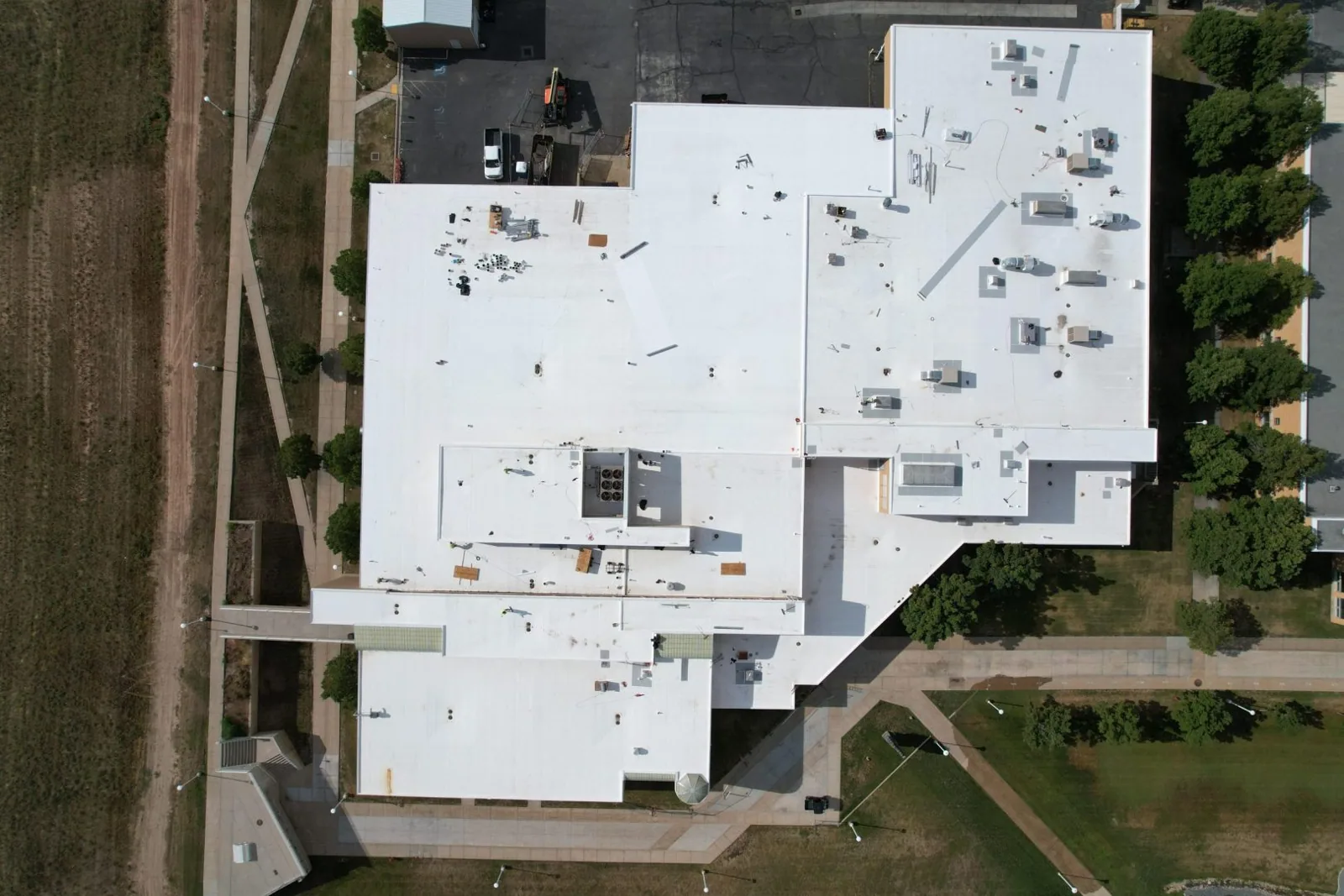

A replacement may carry added insulation now that the 2021 energy code has taken hold. We put that in the range. A restoration coating may defer a replacement on a roof with dry insulation, which stretches a bond. A roof with saturated board belongs in the replacement column. Our roof capital planning reports show that choice in a format the board can adopt.
Unit prices help the district. Price per square foot for sheet. Price per foot for edge metal. Price per unit for boots, drains and curbs. When a hidden condition shows up under the old roof, the change order uses the unit price already in the estimate. No new negotiation. No lost week.
Wind, moss and the weekly check
Roof edges here have seen 67 mph gusts in March 2016 and the easterlies of the November 2024 bomb cyclone, which damaged at least 16 homes in Sudden Valley. School roofs have long perimeters. Edge metal and coping take the pressure. We check fastening on each visit and price resets by the foot.
Moss and algae grow in the damp. They hold water at laps and drains. A district with many roofs cannot treat them all in one week, so the visit calendar rolls through the buildings in order of risk. The fall pass clears scuppers on every flat section before the first big storm. Cheap. Fast. Effective.
Snow is a small item. Snow totals roughly 10 inches in a year, almost all of it in December through February, yet a light snow still blocks a scupper and melt ponds behind a parapet. The fall visit clears scuppers so a school opening after a snow day is not also a school with a wet ceiling.
Schools, colleges and the shared lessons
The city's institutional base reaches beyond K-12. Alongside Western Washington University, with more than 16,000 students, Whatcom Community College and Bellingham Technical College run building sets of their own. A college roof program and a district program share the same method. Grade. Rank. Fund. Install in the break.
Roof work in the Sehome and university area shares streets with campus traffic. Material deliveries and crane lifts avoid peak times. Fences go up around staging. A named supervisor answers at every active school.
Records move with the buildings. When a facilities director retires, the roof file stays. The next person opens one register and sees every roof, every repair and the order of the next five years.
Children on site
Summer work is not always empty. Camps, programs and staff stay on site. Crews work behind fences, keep walkways covered and close access to active areas. Fumes and odor are controlled around open windows and intakes.
During the school year, emergency repairs still happen. A leak over a classroom is dried in the same day, with the room cleared and the opening tarped. The permanent fix waits for the break unless the damage is large. On a school roof, the paper side follows the habits of public agency work: documented submittals, tight change orders and clear closeout photographs.
Closeout is a punch walk with the facilities lead. We probe the welds. We check each drain, curb and edge against the plan. We photograph the finished roof, update the register and hand over warranty papers before school opens.
Commercial Roofing Questions
When should a district start planning a summer project?
The previous fall at the latest. Design, approvals, lead times and bids all need months. A late start pushes the work into the next summer.
Can roofing continue after school starts?
Some work can: repairs and coatings on roofs away from classrooms, with barriers and controlled access. Major tear-off waits for the break.
What happens if a roof fails during the school year?
We dry in the opening, protect the room and report the extent. The district then decides whether to repair now or hold for summer.
How do older roof materials affect the schedule?
Older roofs may contain materials that need testing before disturbance. We recommend testing in the survey phase so any abatement is planned and priced early.
Do you supply documents for bond measures?
We provide condition reports, photographs and cost ranges per building. The district's architect and counsel handle formal bond papers.
Send the campus list and the capital calendar
Send the buildings, roof ages and your funding timeline. We will grade every roof and propose a multi-summer sequence with priced lines.
